Case Study: Factory Floor and Layout Upgrade in Apex banner showing a clean industrial building work zone with slab, structure and safety planning details

Case Study: Factory Floor and Layout Upgrade in Apex

Phased works in a running plant – floor repairs, mezzanine and partition changes without stopping production

Project snapshot

An Apex factory upgrade case study – phased floor repairs, mezzanine and partition changes completed around live production shifts.

14 min read

On this page

Can you modernise a busy production site in Benoni without halting operations or risking staff safety?

In this factory upgrade case study Apex, you will see how phased works and careful planning keep machines running and people safe. The article explains how facility managers co-ordinate floor repairs, site access and material deliveries while production continues.

We outline a practical, contractor-focused approach so you can check timelines, labour and approvals before you request quotes. This is a straightforward guide for property owners, landlords and investors in Benoni who need clear steps and realistic expectations.

Our platform connects you with independent contractors and helps you request up to three building quotes, or up to five where available. Note that contractors carry out the work; the platform only facilitates contact and comparisons.

Read on to learn the phased works required, what to confirm in writing, and how to protect staff and schedules during repairs.

Factory Upgrade Case Study Apex: Project Overview

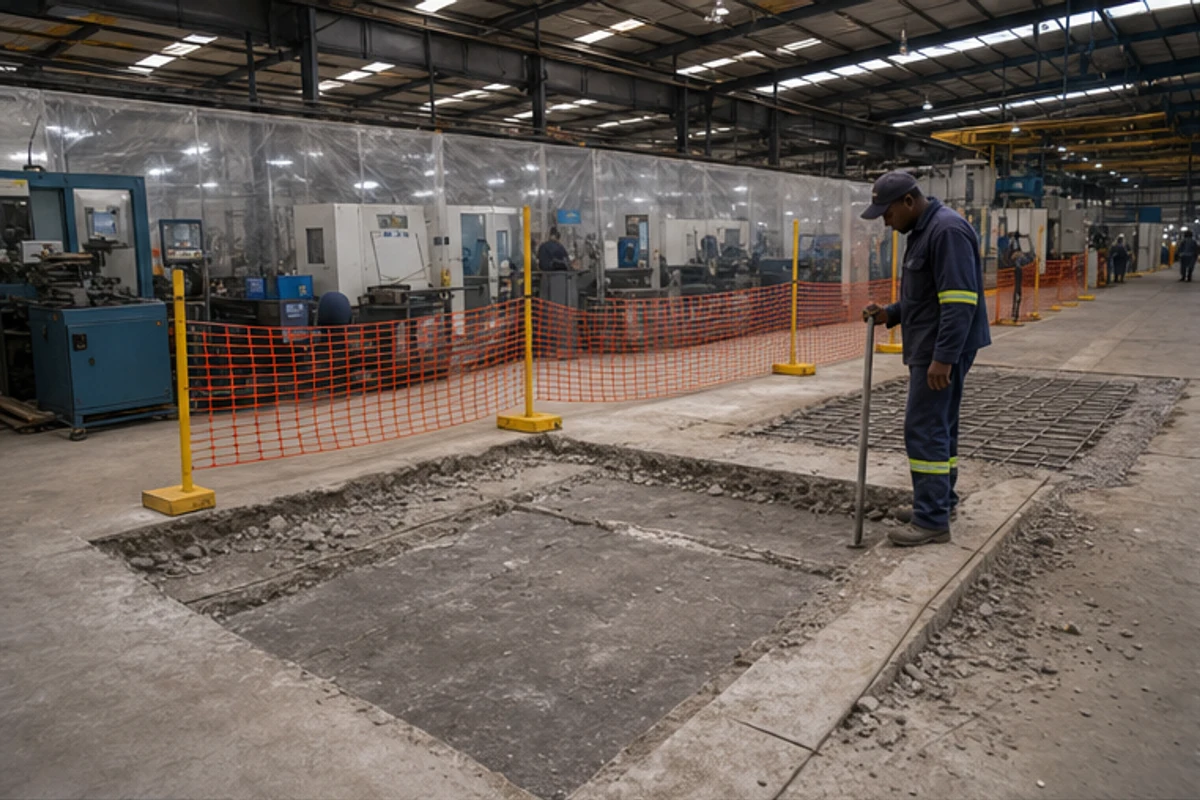

Worker marking a factory floor repair area behind temporary safety barriers
A factory upgrade starts with the exact repair zone isolated.

The facility upgraded worn floors and reworked its layout to lift throughput without stopping production. The site staged the work in phases — repairing spalled concrete, re-screeding and re-marking traffic routes — so machines kept running on the shop floor.

Project Snapshot

The plant runs continuous shifts, so the team sequenced floor repairs and bay changes around production windows. Clear staging cut downtime and kept output steady.

  • Phased floor repairs let single zones close while the rest of the plant ran.
  • Hoarding and marked walkways kept staff clear of active work areas.
  • A better layout and durable flooring reduced handling time and trip hazards.

“Staging the work by zone cut our downtime and kept the line moving.”

Budget and Duration

The project balanced repair budget against the cost of lost production. Management prioritised the zones that would deliver the largest impact on safety and throughput.

Typical timelines covered procurement, systems configuration and staff training. For help finding Apex Industrial builders and local contractors, visit buildingcontractorsinbenoni.co.za to request quotes and assess resource needs for similar projects.

Defining the Scope and Industrial Requirements

Identify which production areas and processes give the biggest return from new technology. Epoxy flooring and layout changes often deliver the fastest wins on a working floor.

Begin by listing the systems, staff roles and processes that touch daily output — our guide to renovating a working factory covers sequencing around production. Discovery calls and a short site consultation help gather accurate information and baseline data.

Specialist industrial contractors bring years of experience phasing repairs around live production for SMEs and larger plants. A structured plan speeds the work and limits disruption across the floor.

Use a simple assessment to rank improvement areas by impact, cost and disruption, as our other Benoni building projects show. That gives clear priorities for the project and helps contractors give realistic quotes.

  • Map traffic routes, load paths and the zones that must stay open.
  • Confirm which crews and inductions each phase needs.
  • Document approvals, materials and on-site support needs.
Scope Element Typical Requirement Impact on Efficiency Support Needed
Process mapping Site walkthrough, flow diagrams High Consultation, data collection
Floor repair Substrate test, screed/epoxy reinstatement High Specialist applicators
Site induction Role-based safety sessions Medium On-site marshals, briefings
Site logistics Access, materials staging Medium Project management support

Operational Challenges in a Running Plant

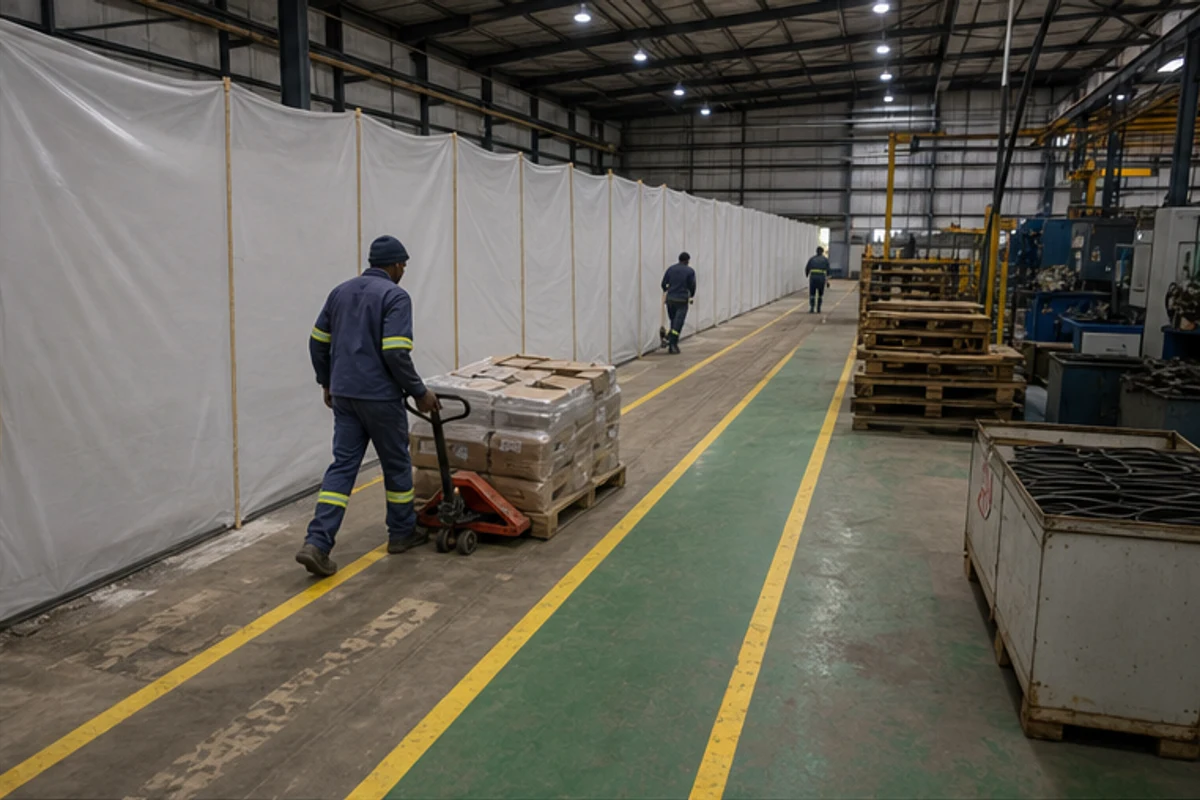

Dust screening separating a production aisle from factory upgrade work
Temporary separation helps the plant keep operating during works.

Running repairs in an active plant demand tight sequencing and clear site rules to keep people safe and production steady.

Managing industrial nodes means juggling deliveries, temporary power changes and work zones without halting output. The focus stays on efficiency and worker safety while teams apply phased development to problem areas.

Managing Industrial Nodes

Processes must be mapped so every team knows the priority and resource plan. Simple, visible schedules reduce confusion and help staff adapt to new systems and applications.

Large industrial operations phase upgrades to keep handling high volumes while power and services stay available. That shows how careful sequencing reduces the impact of works on operations.

  • Practical management: keep data and permits ready for contractors.
  • People first: ensure employees have clear access and induction for each area.
  • Support: use a platform to find contractors who understand phased works in manufacturing environments.

“Successful operations depend on the people involved and their ability to adapt to new systems and processes.”

Phased Works and Logistics Management

Supervisor briefing workers beside hard hats and blank induction forms in a factory
Phased work depends on daily safety and access coordination.

Sequenced site activity depends on tight timing and visible controls to keep systems and teams productive.

Shifts and Hoarding

Phased works demand strict planning so shifts and hoarding do not block production. Staggered access keeps plant areas operational and limits disruption to manufacturing.

Plan clear shift handovers and mark hoarded zones with signage. That reduces downtime and keeps the team safe.

Induction Protocols

Induction is a mandatory step for employees and contractors entering a live work area. Simple, written briefings cut confusion and enforce safety rules.

Include role-specific training, permit checks and a contact list. This lowers risk and improves productivity during development phases.

Logistics Coordination

Coordination needs data-driven scheduling. Use delivery windows and dedicated staging areas so materials arrive on time and do not interfere with operations.

Make resource allocation a priority: assign a coordinator to manage deliveries, lifts and temporary services.

  • Maintain visible daily schedules for shifts and work zones.
  • Use short inductions and sign-off sheets for every visit.
  • Share system access and application details with contractors beforehand.
Area Main Action Priority Expected Impact
Loading bay Timed deliveries, staging High Reduced site congestion
Work zones Hoarding, signage, handover High Safer operations
Training hub Short inductions, refresher sessions Medium Improved compliance
Coordination desk Daily schedule, data logs High Better time and resource use

This platform supplies the data you need to coordinate complex strategies during phased development. By following these practical steps you reduce the impact on daily operations and keep productivity steady in Benoni.

Addressing Older Stock Realities

Many older sites carry legacy power distribution boards and roofing materials that present immediate challenges for phased development. These issues affect safety, timelines and day-to-day operations in Benoni manufacturing areas.

Take a professional approach: treat electrical and roof repairs as a priority in your process planning. Early checks improve efficiency and reduce surprises during works.

Use a structured assessment to check systems, note hazards and gather data. That process helps management assign the right contractors and agree realistic schedules.

  • Inspect power and structural elements before any development starts.
  • Document risks so permits and applications are clear.
  • Stage interventions to limit impact on production and employees.

Our platform provides the data you need to connect with contractors experienced in older industrial systems. Reviewing this case study shows how early action saves time and reduces cost impact during development and application phases.

“Identify legacy issues early to protect investment and keep the site safe for employees and visitors.”

Ensuring Safety and Site Access

Secure, simple access controls protect people and keep production flowing during on‑site works.

Begin by defining a clear process for entry, sign‑in and induction. Share concise information with every contractor and employee before they arrive.

Plan for power isolation and temporary services as part of development work. That reduces surprises and keeps daily operations safe.

  • Use visible signage, authorised ID and a single access point to manage movement.
  • Require short, role‑specific training and written permits for high‑risk tasks.
  • Record data on site visits so management can audit compliance and efficiency.

Our platform supplies the data you need to find contractors who prioritise safety and secure site access. This helps you apply resources efficiently and protect employees while work continues.

Control Main Action Benefit
Access point Single entry, ID check Fewer unauthorised entries
Induction Short, written briefing Faster compliance
Power plan Planned isolations, backups Reduced downtime

Apply these measures during development and include them in your quote request application. That ensures contractors value your facility’s integrity and that the lessons in this case study are put to use.

Lessons Learned for Factory Managers

Practical lessons from this project show how clear priorities and steady management deliver measurable efficiency gains in Benoni.

Start with data and a realistic plan. Use that information to rank processes and spot the highest‑impact development areas. This helps reduce delays and keeps operations steady.

Match system choices to the work you do. Choose technology and training that suit manufacturing needs and the people who use them. That approach lowers risk and speeds optimisation.

  • Strategies: set short milestones and review time regularly.
  • Tool and solution: pick simple applications that cut manual steps.
  • Support: use the platform to find contractors with local expertise.

“People make the project work—train them, involve them and protect their time.”

Use these lessons to identify priorities for your company. A well‑managed project improves product quality, helps employees and secures long‑term success for the development. Review this material and request quotes with clear scopes so every resource is put to best use.

Connecting with Professional Contractors

Find trusted contractors in Benoni through a simple platform that brings project details and tradespeople together.

Use clear data to shortlist professionals. The platform provides the information you need to compare skills, availability and past work.

Search by required expertise so contractors understand live-site rules, shift handovers and material staging. This helps reduce surprises during works and keeps operations steady.

  • Review contractor profiles and qualifications.
  • Confirm availability, local experience and insurance details.
  • Request written scope items to compare quotes fairly.

“Choosing contractors who know the site and the people reduces downtime and improves safety.”

What to check Why it matters Action
References & licences Shows verified competence Ask for recent project contacts
Local availability Reduces travel and delays Confirm lead times and staging plan
Health & safety Protects people and production Require inductions and permits
Quoted scope Allows fair comparison Compare line items and exclusions

Use the platform to request quotes, review profiles and select contractors who match your needs. Independent contractors perform the work; the platform only connects you with options and data to help you decide.

Our Quote Request Process

Start your request by supplying clear information about the site and the work required in Benoni. Include drawings, access notes, staging needs and estimated timelines so contractors can assess the scope accurately.

The platform keeps the process simple. You may request up to three building quotes, or up to five where available. Our average user rating is 4.7 reflecting ease of connecting with local professionals.

We recommend a site visit. A short walk‑round helps contractors collect the data they need and reduces surprises on price and time. This supports accurate quotes and better planning for your employees and shifts.

  • Provide concise project information and preferred visit windows.
  • Ask contractors about their phasing plan and site-management approach.
  • Compare written scopes, exclusions and proposed timelines before you decide.

Our platform does not perform the work; it connects you with independent contractors. Use the quote process to secure the right support for your company and increase the chance of long‑term success.

“A clear brief and a site visit deliver sharper quotes and fewer surprises.”

Sustaining Long-Term Facility Efficiency

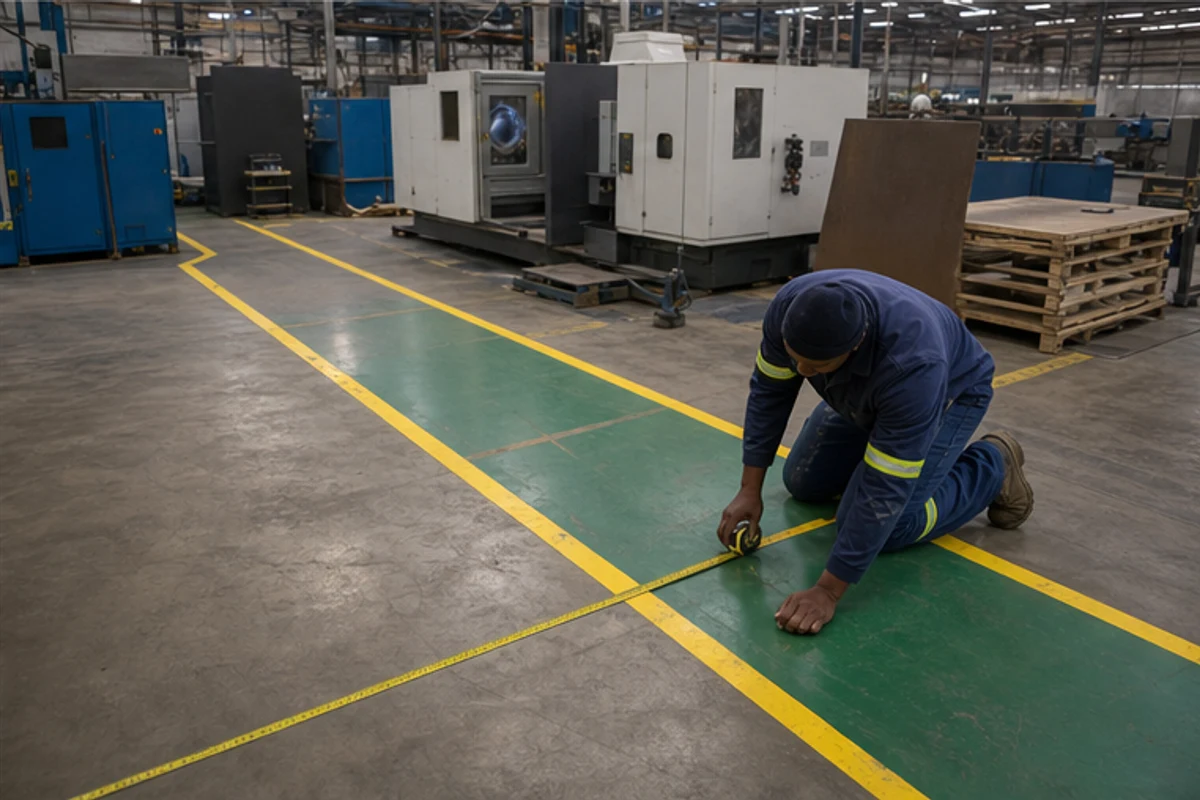

Worker measuring yellow floor lines around equipment in an industrial workshop
Floor layouts should support production movement after the repair is complete.

A proactive approach for maintenance, training and system optimisation secures long-term efficiency.

Keep processes simple and use data to spot where technology or power management will lift productivity. Small additions to equipment or digital tools often deliver measurable gains.

Use the platform to find contractors who provide the right solutions and support for Benoni sites. The data supplied helps you compare quotes and confirm training, timelines and approvals.

Request a site visit today to assess your needs and start planned initiatives that improve sustainability and operational success. Book a visit and take the next step toward lasting efficiency.

FAQ

What does the project title “Case Study: Factory Floor and Layout Upgrade in Apex-Phased works in a running plant – floor repairs” mean for my site?

It describes a phased programme of floor repairs and layout adjustments carried out while the plant remained in operation. The work is staged to limit downtime, with hoarding, night shifts and strict safety controls to keep production running and people safe.

What is included in the Project Overview for a running-plant floor and layout upgrade?

The overview lists the scope, critical nodes to keep running, phasing plan, temporary access routes, materials and labour plans, environmental controls and key milestones for each phase. It also sets out budget assumptions and contingency allowances.

What does the Project Snapshot usually show?

A snapshot highlights the site, main objectives (for example repair spalled concrete and extend pallet bays), duration for each phase, core teams involved, PPE and induction needs, and expected impact on production lines during each shift.

How is Budget and Duration estimated for phased works in an active plant?

Estimation combines measured quantities, plant access constraints, premium shift rates, temporary works, specialist testing, and allowances for overtime and supply-chain delays. Duration is phased to match production windows and allow for curing times of repair products.

How do you define scope and industrial requirements before starting work?

The team surveys the floor condition, maps services and load paths, tests substrate strength, and confirms tolerances with operations. This informs surface prep, repair methods, load-bearing reinstatement, and any layout changes required for handling and machinery.

What operational challenges arise when working in a running plant?

Challenges include keeping production safe, controlling dust and noise, coordinating deliveries without disrupting shifts, maintaining access for emergency services, and sequencing work around critical equipment and inspections.

How are industrial nodes managed during the project?

Teams identify critical nodes—loading docks, conveyors, control rooms—and set out bespoke protection and isolation plans. Temporary ramps, alternate routes and phased shut-offs reduce the risk of disrupting those nodes.

What is involved in Phased Works and Logistics Management?

Phased works break the site into manageable areas. Logistics management aligns material deliveries, plant movement, waste removal and contractor access with shifts and production schedules to avoid bottlenecks.

Why might shifts and hoarding be required and how are they planned?

Night or weekend shifts reduce daytime disruption. Hoarding creates safe zones between works and operations. Plans cover lighting, ventilation, access gates and clear signage so both crews and operators know boundaries.

What induction protocols do contractors follow on an active manufacturing site?

Inductions cover site rules, emergency procedures, PPE standards, permitted routes, toolbox talks on specific hazards, and sign-off on any work permits such as confined space or hot work permits.

How is logistics coordination handled to minimise impact on production?

Logistics coordinators schedule deliveries to off-peak times, use laydown areas away from operations, stage materials by phase, and liaise daily with plant supervisors to adjust plans if priorities change.

What special considerations are there for older stock and existing materials?

Older substrates may hide reinforcement corrosion, voids or contamination. The team tests cores, inspects for historic repairs, and chooses compatible repair mortar or overlays to avoid premature failure.

How is safety and site access ensured throughout the upgrade?

Measures include perimeter hoarding, segregated walkways, permit-to-work systems, regular safety audits, trained marshals during deliveries, and clear emergency access routes maintained at all times.

What lessons do managers usually learn from phased upgrades in running plants?

Common lessons are to allow extra time for coordination, budget for night shift premiums, keep communication channels open with operations, and invest in detailed temporary works and traffic plans to avoid surprises.

How can I connect with professional contractors for a similar project in Benoni?

Request quotes from contractors experienced in industrial repairs and phased works. Provide clear scope, access times, and drawings. Ask for references from similar running-plant projects and proof of insurance and compliance.

What does the quote request process involve on this platform?

You submit site details, photos, preferred access times and scope. You can request up to 3 quotes, or up to 5 where available. Contractors arrange site visits, produce final quotes, and manage their own timelines and warranties.

How do you sustain long-term facility efficiency after completing repairs?

Put a maintenance schedule in place, monitor high-traffic zones, use appropriate coatings or overlays, train staff on correct handling and traffic routes, and budget for periodic inspections to catch wear early.

What local considerations should Benoni property owners confirm in writing before work begins?

Confirm start and finish dates, access windows, materials and product brands, traffic and delivery plans, waste removal method, liability and warranty terms, and who will manage permits or inspections.
